Test logs, not adjectives

A load rating is a claim until a frame has held it, and a coating warranty is a promise until a coupon has survived the chamber. So RackForge publishes the tests instead: every frame passes an outgoing sequence that covers structure, coating, grounding and — on liquid-ready builds — a 24-hour manifold pressure hold. The log below is the shipped format, printed with the frame's serial number and put in the crate, not in a claim portal.

Request a Quotation Jump to Test Standards

4× static · 72-h creep recheck · class 0 adhesion · ≤0.1 Ω ground · 1.5×/24 h pressure

Outgoing Log

The record that leaves with the rack

Eight checks close an outbound build; the example below is a high-density GPU frame with the liquid-ready option, which is why both the load line and the manifold line appear. Air-cooled standard frames run the same sequence minus the pressure hold. Results are recorded against the serial number stamped on the frame.

rf-qc — outbound quality log · batch QF-2609-082
$ rf-qc --sku RF-48U-800x1200-GPU --stage outbound --report full STATIC LOAD ......... 4x rated (6,400 kg) held 72 h .............. PASS CREEP RECHECK ....... deflection 0.8 mm < 1.0 mm limit ........... PASS COATING ADHESION .... ISO 2409 cross-cut, coat 90 µm ............. CLASS 0 GROUND CONTINUITY ... frame-to-frame 0.08 Ω, limit 0.1 Ω ......... PASS MANIFOLD PRESSURE ... 1.5x working, 24 h hold, zero drop ......... PASS DIMENSIONAL ......... CMM first article, ±0.1 mm envelope ......... PASS SALT SPRAY .......... ISO 9227 NSS, batch coupon, 480 h ........... PASS FINAL VISUAL ........ finish, fit and hardware checklist ......... PASS log ships inside the crate · serial-matched to the frame · cover 42U–52U lines
Shipping Dossier

What is in the crate besides the rack

Six documents travel with every order, so customs, site crews and the warranty file each get the page addressed to them. The test record and drawing package are revision-matched to the serial number on the frame — the version in the crate is always the version that was built.

Factory test record — the outbound log above: load, creep, adhesion, ground, pressure and visual results, serial-matched.

per frame

Drawing package — as-built general arrangement plus anchor and bayning layout for the site crew.

rev-matched

Packing list — crate contents by serial, with accessory kits and hardware bags itemised for unpacking checks.

per crate

Warranty card — 3-year terms on structure, coating and factory-fitted components, with the claim path and response window.

3 yr

CE declaration of conformity — LVD, EMC and RoHS directives; EN IEC 62368-1 cited where electrical accessories are fitted.

per shipment

Spare parts list — hinges, locks, brush strips and blanking panels with reorder codes for a 30-day restock path.

per order
Test Standards

Every check, with its method, limit and frequency

Published so your QA team can compare line-for-line against the rack standard you write. Where a frequency is batch-based, the batch coupon number is recorded on the shipment dossier so results stay traceable to your crates.

TestMethodAcceptanceFrequency
Static loadweighted plates on installed rails4× rated — 1,500 kg standard / 1,600 kg high-density, no permanent setevery high-density frame; first article + batch sampling on standard
Creep recheckdeflection read at 24 h vs 72 h under loadΔ ≤ 1.0 mmevery high-density frame
Coating adhesionISO 2409 cross-cut on coated panelclass 0every coating batch
Coating thicknessmagnetic gauge, 5 points per panel80–100 µmevery coating batch
CorrosionISO 9227 neutral salt spray, batch coupon480 h — no red rust, no blisteringevery coating batch
Ground continuity4-wire milliohm meter, frame-to-frame≤0.1 Ωevery frame
Manifold pressure1.5× working pressure, sealed holdzero pressure drop in 24 hevery liquid-ready rack
Dimensionalgranite CMM against ballooned drawing±0.1 mm fabrication envelopefirst article per batch + 5% sampling
Door mesh open areaaperture measurement on front mesh≥80% open areaper door lot
Torque auditcalibrated wrench on sampled jointsper assembly specification, log entry requiredevery frame
Final visual & packingfinish, fit, hardware and crate conditionchecklist pass before cratingevery frame

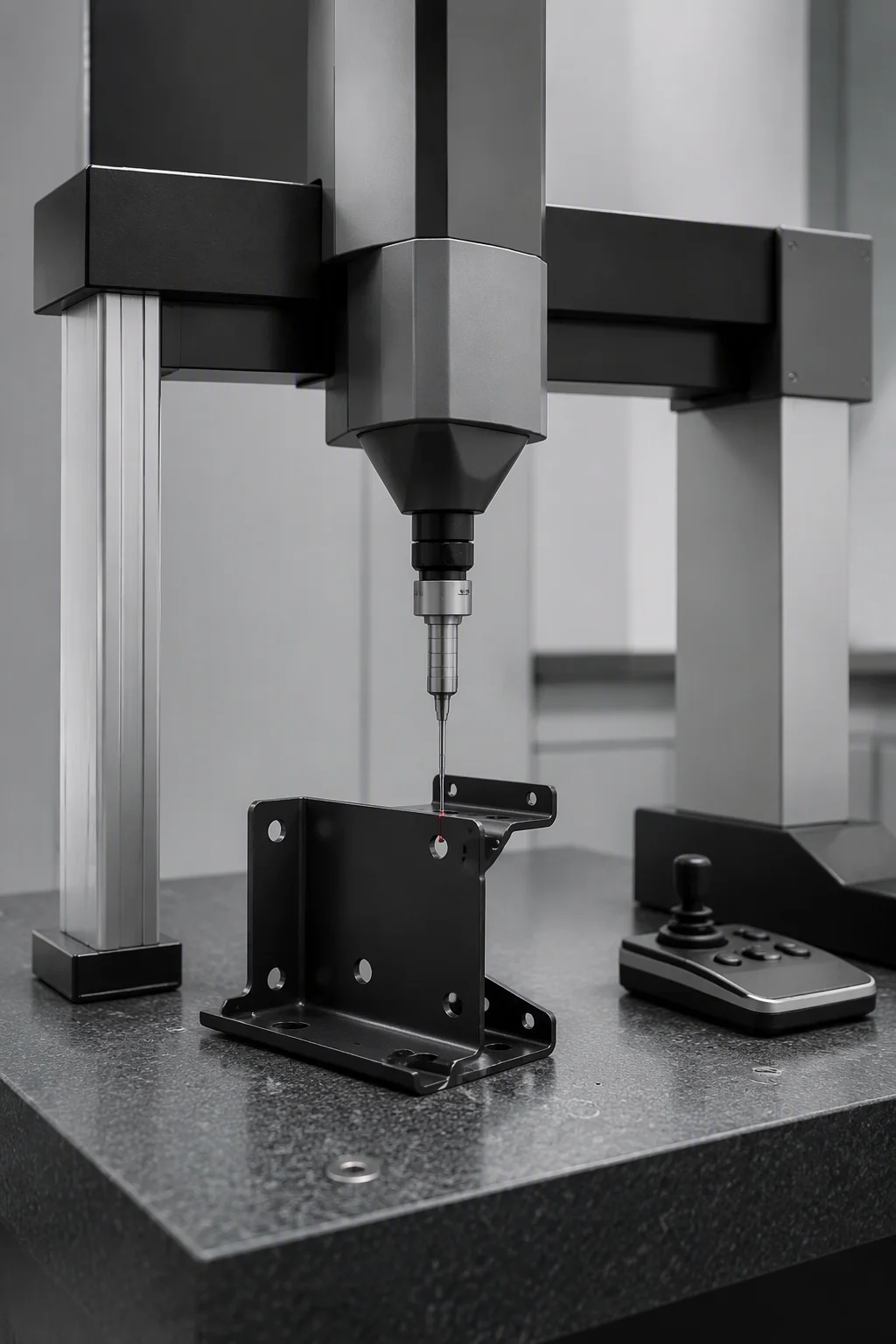

Coordinate measuring machine probing a rack upright on a granite table in the inspection room
CMM ROOM — first articles proved on granite before a batch is released to coating
Measurement

First on granite, then on the floor

Every batch starts with a first article on the CMM: column spacing, EIA hole pattern, rail positions and door openings are probed against a ballooned drawing, and the ±0.1 mm envelope is signed before coating is allowed to start. Spot checks continue at 5% through the run, so a worn die or a drifted brake shows up inside a shift, not inside your container.

The same logic runs the other direction. If a field question ever arises, the serial number on your frame points back to its batch coupon, its first-article report and its outbound log — which is what makes the 3-year warranty a document trail rather than a promise. Ask for the dossier with any quotation and we will send a redacted sample log with the drawings.

±0.1 mm first article · 5% in-run sampling · serial-to-batch traceability

Brushed steel texture

Ask for the test log before you buy the load rating

Serial-matched records · 4× static, 72 h · MOQ 5, samples in 15 days
